Mastering Construction Site Coordination and Execution

Published: at 03:58 PM

Fitoutsequence

Table of Contents

Open Table of Contents

Introduction

In the built environment, the construction site is where planning meets execution. While architectural designs and schedules are born in offices, it’s in the field that delays, overruns, and quality issues manifest.

A Construction Site Supervisor plays a pivotal role in translating technical drawings into physical reality — safely, cost-effectively, and on time. This post breaks down my professional approach to managing construction sites, ensuring alignment across stakeholders, maintaining regulatory compliance, and upholding quality.


Key Responsibilities of a Site Supervisor

Whether in urban high-rise developments or remote housing estates, the foundation of successful site management revolves around:

A good supervisor balances operational efficiency with adaptability — adjusting schedules and team deployment based on weather, supply chain issues, or site conditions.


Effective Resource Allocation

Managing a construction site isn’t just about directing labor — it’s about optimizing time, equipment, and materials. Here’s how I approach it:

Example: When coordinating backfilling and slab casting, I use a material log sheet updated twice daily to ensure aggregates and cement are on standby before mobilizing formwork teams.

Managing Subcontractors and Site Teams

Interior and structural works often involve multiple subcontractors — each with different expectations, deliverables, and work rhythms.

Here’s how I manage them effectively:

Supervisors who respect each subcontractor’s needs and constraints will get the best work out of them.


Monitoring Progress and Ensuring Quality

Quality assurance isn’t something you do at handover — it starts on Day One. Here’s how I approach quality on site:

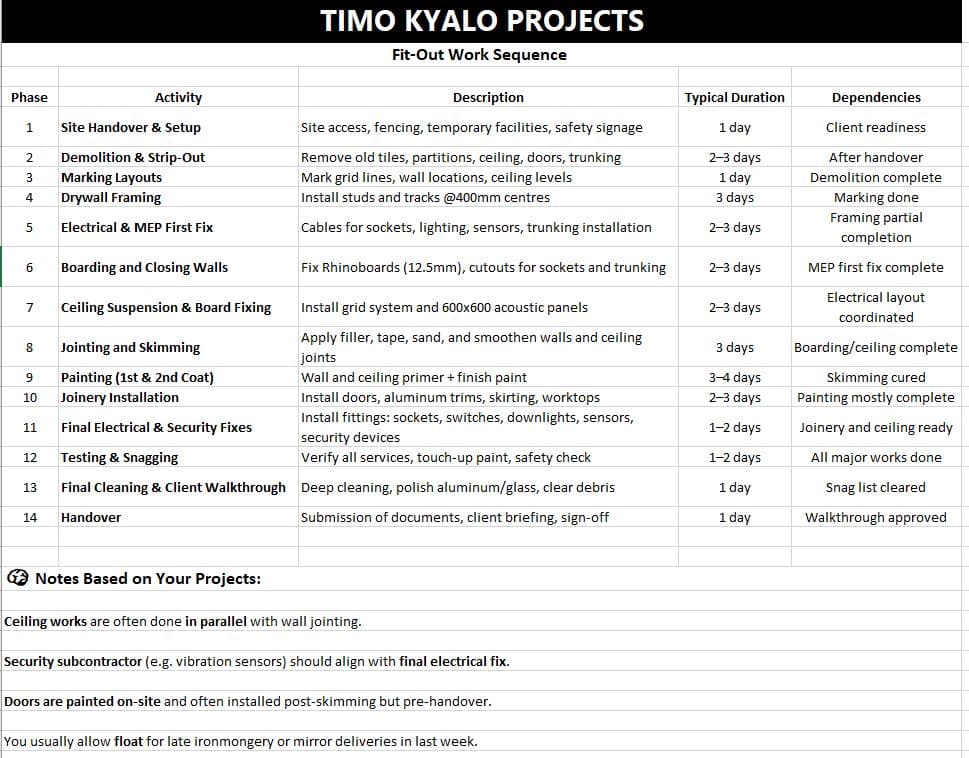

Case Study: NCBA Tatu City Interior Fit-Out

During the NCBA Tatu City fit-out, we had less than 90 days to fully fit the space with MEP, partitions, ceilings, and finishes. It was a fast-paced, multi-trade coordination challenge.

My role included:

The project was completed without major overruns, thanks to daily supervision, planning tools, and consistent site reporting.


Conclusion

Construction site coordination is both a science and an art. While tools like Microsoft Project, checklists, and daily reports matter, it’s your presence, discipline, and decision-making that keep things moving.

Whether it’s a bank fit-out, a housing scheme, or a retail rollout — great execution starts with the site supervisor.
